Join Us Reconstruct School Building Ravaged by Cyclone

Manipur has encountered one of the worst cyclones on 15th April. It wreaked havoc mostly in Churachandpur, Bishnupur and southern part of Kakching district. A terrible situation has happened in Kwakta at Manipur Creative School (MCS) when the storm ravaged the whole school building where normal classes were going on in the campus on 15th April 2019. The school had 12 Classrooms, 1 Hostel, 1 Administrator room, 1 Staff room, 1 Principal room, 1 Prayer Hall and 1 Store room, 1 Warden room and a Waiting Shed. The casualty left 29 persons injured including 18 students, 10 teachers and 1 gatekeeper out of which 5 are in critical and fortunately no loss of life.

The Manipur Creative School is run and managed by Education Support Society (ESS) having 9 members from different walks of life and truly inspired by pioneering people in the field of education from all over the world. The society has till now established two campuses which are recognized by State Govt. and affiliating through CBSE, one in Kwakta in 2016 and the other in Imphal in 2017. Both campuses have up to 8th standard. Till now, the school is funded by the promoters of the society.

29 PERSONS INJURED
It has been one of the dream projects for the members to establish a society of responsibility or a civilized one by molding the younger generations through lateral thinking, pragmatic experiences and other curricular works which reduces the gap between school, home and community. However, this process will be freezed for at least 45 days or till new school building is constructed. The society has no option to arrange such a big amount within such short span of time. Unless we do not construct the building and resume the class, the future of the 400+ students of the Kwakta campus will be ruined and confidence of parents which we have been building up since 2016 cannot be restored.

RECONSTRUCTION OF SCHOOL WITHIN 45 DAYS
We have no option but to appeal to every philanthropist, educationists, pioneers of the society to come forward and do little contribution which will be immensely helpful to rebuild the campus as soon as possible. Even a penny counts!

http://essgroupofschools.com/school-building-ravaged-by-cyclone/

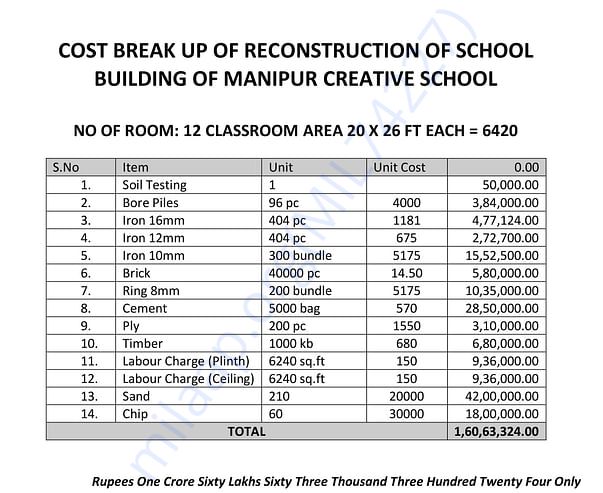

Cost Break up of the construction of 12 rooms RCC Building
Cost Break up of the construction of 12 rooms RCC Building
Cost Break up of the construction of 12 rooms RCC Building
Cost Break up of the construction of 12 rooms RCC Building
PAN Card
PAN Card
NGO Registration certificate
NGO Registration certificate

Medical Bill of one of the Patients
Medical Bill of one of the Patients

Report of the Damage by Cyclone in Ichel Express (www.ichelexpress.com
Report of the Damage by Cyclone in Ichel Express (www.ichelexpress.com
Ask for an update
16th May 2019
Dear Supporters,

Thank you very much to all donors for their support. We could not get the target of our donation but you have really fulfilled your responsibility. The construction part is yet to be initiated but to keep the classes going on, we have arranged a temporary building where the class is now going on.

Normal classes resumed 29/04/2019 and it will continue at the temporary building till school is constructed. Soil testing has been done and report is still waiting. Once we get the ground works done, we will start the construction process with the target to complete by 2019 for the atleast minimum required rooms to run the school.

Keep supporting us and all those who are in need of any sort of help.

Thank you.
Dear Supporters,

Thank you very much to all donors for their support. We could not get the target of our donation but you have really fulfilled your responsibility. The construction part is yet to be initiated but to keep the classes going on, we have arranged a temporary building where the class is now going on.

Normal classes resumed 29/04/2019 and it will continue at the temporary building till school is constructed. Soil testing has been done and report is still waiting. Once we get the ground works done, we will start the construction process with the target to complete by 2019 for the atleast minimum required rooms to run the school.

Keep supporting us and all those who are in need of any sort of help.

Thank you.
Content Disclaimer: The facts and opinions, expressed in this fundraiser page are those of the campaign organiser or users, and not Milaap.
Rs.44,450 raised

Goal: Rs.10,000,000

Beneficiary: Education Suppo... info_outline
Only INR donations accepted

Supporters (26)

MA
Md donated Rs.2,000

May the reconstruction effort be a success

A
Anonymous donated Rs.1,000
AH
Aabid donated Rs.1,000

School Reconstruction

DM
Dr Muhammad donated Rs.2,500
SP
Shaheda donated Rs.3,000

lets build it together...

A
Anonymous donated Rs.500
